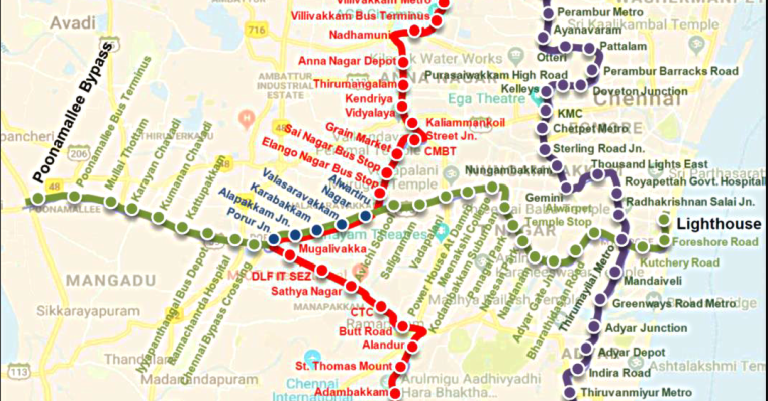

CMRL’s Phase II Project to extend till Greenfield Airport

CHENNAI (Metro Rail News): The 118.9-km Phase II project of the Chennai Metro Rail is expected to cover another 93 km, with the goal of extending it to Parandur, where a greenfield airport has been proposed.Three corridors have been planned for the 61,843 crore Phase II project: Corridor 3, which covers the 45.8 km Madhavaram-Siruseri line, Corridor 4, which covers the 26.1 km Lighthouse and Poonamallee, and Corridor 5, which runs from Madhavaram to Sholinganallur (47.0 km). Corridor 5 to Avadi via Thirumangalam and Mogappair (17 km), Corridor 4 to Parandur (50 km), and Corridor 3 from Siruseri to Kilambakkam Bus Terminus via Kelambakkam (26 km) will all be extended.According to CMRL officials, a consultant will soon be hired to conduct a thorough feasibility study for these extensions and submit a report with recommendations.“We have just floated a request for a proposal to select a consultant for these corridors. The consultant will go through the existing reports such as the comprehensive mobility plans, the present transport routes, and development plans. The consultant will come back to us with a report in a few months,” an official stated.The report will cover a variety of topics, such as traffic congestion, peak-hour travel, projected travel demand for these corridors over the next 30 years, estimated construction costs, the need for both public and private funding, social and environmental impacts, and various other factors.The Metro Rail will be extended from the Chennai airport to Kilambakkam, where a bus terminal will soon be constructed. The CMRL has provided the State government with a thorough project report.According to the sources, this line will allow commuters access to the bus terminus from a variety of locations.After the major areas of the city are covered, the route to Parandur is likely to have fewer stations than the other stretches, the sources said.

Trial run for Joka- Esplanade Metro’s first phase completes smoothly

KOLKATA (Metro Rail News): The maiden trial runs on the Joka- Taratala stretch of the Joka- Esplanade Metro Project was conducted successfully on 15th September.



Arun Arora, general manager of Metro Railway, was informed by representatives of Rail Vikas Nigam Ltd (RVNL), who is responsible for carrying out the majority of the city’s Metro projects, that the priority section, which consists of six stations (Joka, Thakurpukur, Sakherbazar, Behala Chowrasta, Behala Bazar, and Taratala), is ready.

The 6.5 km segment of the 14 km Joka Esplanade Metro project will be operated only after successful train trials and the subsequent approval from the Commissioner of Railway Safety (CRS), who approves any new Metro line in India. The corridor, a pet project of Chief Minister Mamata Banerjee and the railway minister, has repeatedly missed deadlines. It had been flagged off by her in July 2011.

A non-AC rake that is no longer in service in the North-South Metro will be used for the trials. On July 28, the first coach of the eight-car rake was brought out of the Noapara carshed. The rake, which was put together at the Joka depot and tested there, is now prepared to be mounted on the viaduct for its maiden run to Taratala Metro station.

The Joka Taratala Metro and the New Garia-Ruby section of the New Garia-Airport corridor will run on the “one-train-only” system, which entails running without signals.

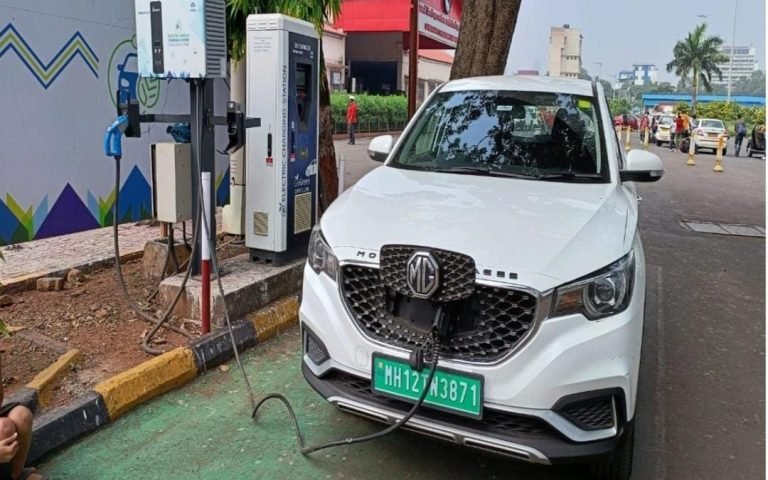

Central Railway set up EV charging facilities at Important stations in Mumbai divisions

MUMBAI (Metro Rail News): Central Railway, contributing to the Government’s endeavor to reduce carbon emissions, has set up 9 EV (Electric Vehicle) charging facilities at important stations in Mumbai Division.

Central Railway has provided EV charging facilities at 9 stations i.e Chhatrapati Shivaji Maharaj Terminus, Dadar, Byculla, Parel, Kurla, Lokmanya Tilak Terminus, Bhandup, Kalyan, and Panvel.  EV charging facilities at these important Railway stations will boost e-mobility, as an important step towards environmental stability as it reduces carbon emission as well as improves the quality of life of people apart from facilitating low maintenance requirements. This public charging facility at the Railway stations is functional 24×7 and will also augment the charging infrastructure for EVs to operate smoothly, bringing great relief to people, as they can charge their EVs at key locations near Railway Stations. The provision of this EV charging facility through the Non-Fare Revenue Scheme also brings in additional income to Central Railway apart from promoting Green Initiatives.

With the large no. of vehicles o­n the road in Mumbai, these Electric Vehicle charging facilities at Railway stations will provide affordable, efficient, and reliable charging points thus encouraging more electric vehicles o­nto the road and helping to promote healthier air and a clean environment.

Provisions of EV charging points is another ‘Green initiative’ step amidst many key initiatives taken by Indian Railways like 100% electrification in coming years, reduction in energy consumption, and meeting energy demand through the creation of Renewable energy like Solar & Wind energy.

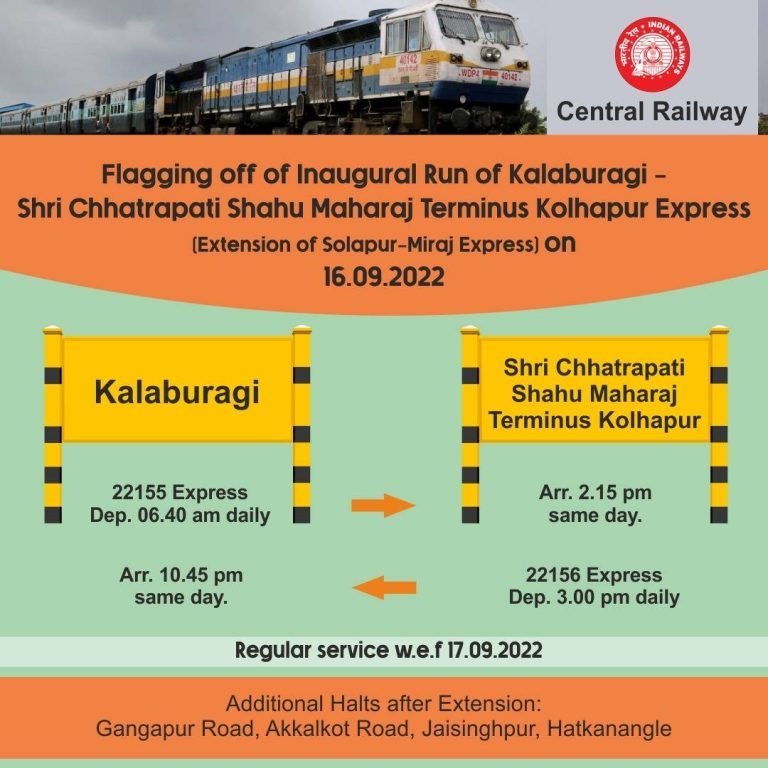

Kolhapur Express will be flagged off from Kalaburagi station today

KOLHAPUR (Metro Rail News): Shri Pralhad Joshi, Hon’ble Minister of Parliamentary Affairs, Coal and Mines, Shri Mallikarjun Kharge, Hon’ble Leader of Opposition (Rajya Sabha), Shri Raosaheb Dadarao Patil Danve, Hon’ble Minister of State for Railways, Coal & Mines, Government of India, Shri Murugesh Nirani, Hon’ble Minister of Large and Medium scale Industries, Government of Karnataka and District Incharge Minister, Kalaburagi, Dr. Umesh G Jadhav, Hon’ble Member of Parliament (Lok Sabha) and Shri Dattatreya C. Patil Revoor, Hon’ble MLA are invited to flag off the inaugural run of Kalaburagi-Shri Chhatrapati Shahu Maharaj Terminus, Kolhapur Express (Extension of Solapur-Miraj Express). The train will be flagged off from Kalaburagi station o­n 16.09.2022.

01455 Inaugural special will leave Kalaburagi at 11.18 hrs o­n 16.9.2022 and arrive Shri Chhatrapati Shahu Maharaj Terminus Kolhapur at 18.30 hrs same day. 01456 special will depart Shri Chhatrapati Shahu Maharaj Terminus Kolhapur at 20.10 hrs o­n 16.9.2022 and arrive Kalaburagi at 03.25 hrs o­n 17.9.2022.

Regular services will commence from 17.9.2022 as per details given below: 22155 Express will leave Kalaburagi at 06.40 hrs daily and arrive at Shri Chhatrapati Shahu Maharaj Terminus Kolhapur at 14.15 hrs same day.

22156 Express will leave Shri Chhatrapati Shahu Maharaj Terminus Kolhapur at 15.00 hrs daily and arrive Kalaburagi at 22.45 hrs same day.

Halts are Gangapur Road, Akkalkot Road, Solapur, Kurduwadi, Pandharpur, Miraj, Jaisinghpur, Hatkanangale.

Composed of 10 Second Class seating( 2 reserved & 8 unreserved) and 2 General Second Class cum Guard’s Brake Vans.

Passengers are requested to avail the facility.

Haryana Govt. proposes cost-effective Pod cars to boost airport connectivity

HARYANA (Metro Rail News): The Haryana government has proposed a personalized, cost-effective rapid transport system based on Pod cars in order to provide faster connectivity between the new terminal building which is located in Mohali, and the old Chandigarh International Airport terminal. Haryana Chief Secretary Sanjeev Kaushal presented the Pod car proposal in a recent meeting which was called by Punjab Governor-cum Chandigarh Administrator Banwari Lal Purohit and attended by senior officers from Haryana and Chandigarh.

The proposal will reduce the long road trips and presently residents of Chandigarh, Panchkula, and some areas of Mohali currently will be benefitted.

Chandigarh International Airport Limited is a joint venture between the governments of Punjab and Haryana and the Airports Authority of India (AAI) incorporated under the Companies Act of 2013.

The runway of the airport is in Chandigarh, and the international terminal is in the village of Jhiurheri, Mohali which is on the south side of the runway.

He said that the current connectivity to the International terminal is such that passengers coming from Himachal Pradesh, Panchkula, and Ambala side International Airport have to cover a longer distance to reach the new international terminal.

Sanjeev Kaushal said that Haryana Metro Rail transport Corporation (HMRTC), a wholly-owned company of the Haryana Government, under Haryana Shahari Vikas Pradhikaran, has proposed a Pod car system to connect the old Airport terminal to the new Airport terminal which is cost-effective, convenient and requires only about 6 acres of land along the boundary of Chandigarh International Airport.

Road connectivity along the boundary wall of the IAF station was also proposed after clearing all obstructions within its 100 meters. This would have reduced the distance by 8-9 km. However, it involves the acquisition as well as the demolition of illegal construction. Due to this & various other reasons the road connectivity projects also hang in the air, said the Haryana government statement.

L&T wins contract to lay tracks for Chennai Metro Phase II Corridor

CHENNAI (Metro Rail News): Larsen & Toubro won the contract to laid ballastless tracks for nearly a 36km elevated stretch on Chennai’s phase 2 metro corridors from Chennai Metro Rail Limited (CMRL) for Rs 340.6 crore.

According to a press release from CMRL, L&T will lay tracks and complete all related work between CMBT and Sholinganallur covering nearly 26km on corridor 5 and from Sholinganallur to Sipcot on corridor 3 of phase-2.

Supplying head-hardened rails, turnouts, and fasteners, and installing ballastless tracks in elevated sections, including 35 metro station locations, pocket tracks, and stabling lines of phase 2 are all part of L&T’s work.


The company is also working on five different phases of phase-2 corridor construction.

Italian government to control 30.30% share of Titagarh Firema

TITAGARH (Metro Rail News): Titagarh Wagons Limited (TWL) informed all stakeholders that, in a significant milestone transaction, the Italian government, through its investment arm- Invitalia, had purchased a strategic position in Titagarh Firema Spa (TFA) which is a subsidiary of Titagarh Wagons Limited.

The Italian government will then hold a 30.30 percent ownership stake in Titagarh Firema in exchange for a 10 million euro investment.

Their investment was then followed by one from the UAE-based private equity fund Hawk Eye DMCC. It spent 4.5 million euros and acquired 13.64% of the company’s equity share capital.

The company’s current founders and owners (Titagarh Bridges & International Pvt Ltd.) have also contributed 5.4 million euros as part of the investment agreement and recapitalization plan signed by TFA with the Government agency and the Private Equity fund.

The newly issued equity had a face value of 1 euro per share, giving the business enterprise value of 118 million euros and an equity valuation of 33 million euros.

The recapitalization process will increase TFA values and create overall value in this strategic transaction. The Company along with its subsidiary Titagarh Bridges & International Private Limited (TBIPL), still owns shares of 16.40 million euros or 49.70 percent of TFA.

Titagarh Wagons was trading at Rs162.85 up by 4.06% from its previous BSE closing price of Rs156.50.

Tata Sons to invest Rs 975 crore in Pune IT City Metro Rail

PUNE (Metro Rail News): Tata Sons, the holding company of the Tata group, is investing Rs 975 crore in Pune IT City Metro Rail, a special purpose vehicle that obtained the contract to build, operate, and maintain the project between Shivaji Nagar and Hinjewadi in the city.

74% of the SPV is owned by Tatas, and the other 25% is owned by Siemens Project Ventures. According to a financial source, the 23-km of Rs 7,420-crore project is being financed with a debt-to-equity ratio of 1.8 times, the full debt has been secured, and Tata Sons is supporting the planned equity participation. The Maharashtra and Union governments each have a 50% share in the development of the Pune metro rail.

Tata Sons, which had standalone debt of Rs 30,000 crore as of March this year, is planning to raise funds via issuing non-convertible debentures. Tata Sons are also looking at listing its satellite TV broadcasting arm, Tata Play, to raise around Rs 3,200 crore.

According to bankers, Tata Sons is concentrating on enhancing the profitability of its digital, electronics, and aviation businesses. Some entities, such as the Pune metro SPV, may need investment from Tata Sons as growth capital because TRIL is concentrating on retiring its debt. Tata Sons are likely to seek out extra debt financing for these projects in addition to spending its own cash, which is anticipated to come in the form of dividend income in the current fiscal year,

Tata Sons, as of March had a standalone debt of Rs 30,000 crore and intends to raise money by issuing non-convertible debentures. Tata Sons are also considering offering Tata Play, its satellite TV broadcasting division in order to raise about Rs 3,200 crore.

“Tata Sons also owns stakes in profit-making insurance companies and may look at raising funds by selling part of their stakes,” the banker said.

TRIL is planning to sell its recently commissioned roads and ropeway projects to raise funds and retire its own debt.

Teltronic to supply and integrate broadband solutions for Delhi-Meerut RRTS Corridor

Zaragoza (Metro Rail News): Teltronic, a Spanish company specialised in the design and manufacture of critical communications solutions has been selected by Alstom to supply and integrate the on-board equipment, radio terminals and control centre solution that will provide Mission Critical Services MCX (MCPTT & MCData) for the Delhi to Meerut Regional Rapid Transit System (RRTS), a high-speed commuter rail currently under construction that will link these two important Indian cities via an 82 kilometres rail corridor.
This project demonstrates the validity of Teltronic’s communication solutions over MCX (critical broadband communications applications and the infrastructure that supports them) defined by the 3GPP standard; a technology that will allow the line operator a
smooth transition to FRMCS (Future Rail Mobile Communication System) in the future.
In this way, Teltronic will provide its Control Centre solution, CeCoCo, with a total of ten operator stations. In addition to being the onboard communications management platform based on 3GPP MCX and connected to a third-party MCX server, it incorporates a Geographic Information System (GIS) that allows real-time visualisation of the location of terminals and trains, and will be integrated with the Train Management System and will also allow communications with the public address and intercom systems.
As a part of the solution, Teltronic will also equip the trains with its on-board solution, consisting of an RTP-800 on-board unit in each cabin, an RCC-3000 touchscreen control console and audio accessories that will be equally integrated with the public address and intercom systems on the train, and with the TCMS (Train Control & Management System). The Teltronic onboard units will be connected to the Alstom NetBox mobile router managing the train-to-ground connectivity for all services.
Finally, Teltronic will also supply more than 600 LTE terminals, both desktops and rugged portable terminals that will be used by the line’s operations and maintenance staff.
“This project is a clear demonstration that our solutions for railway environments comply with the 3GPP standard for MCX services. Teltronic reaffirms its commitment to standards as a reference framework and after a clear target for R&D to evolve our solutions to the technologies of the future, we are proud that Alstom has selected us and that we can demonstrate that Teltronic will continue to play a key role in private communications”, explained Felipe Sanjuán, Transport Business Development director.

Siemens launches open digital business platform ‘Siemens Xcelerator’ in India

MUMBAI (Metro Rail News): Siemens announced the launch of ‘Siemens Xcelerator’ in India at its Annual Flagship event ‘Siemens India Innovation Day 2022’ in Mumbai on 14th September 2022. Siemens Xcelerator is an open and evolving digital business ecosystem that comprises a comprehensive, curated portfolio that includes digital and Internet of Things (IoT)-enabled offerings (software, hardware, and digital services) from Siemens, and certified third parties​.

Siemens Xcelerator is aimed at accelerating digital transformation and value creation for customers of all sizes in the industry, buildings, grids, and mobility. The curated portfolio of software, IoT-enabled hardware, and digital services follow key design principles of interoperability, flexibility, openness, and as-a-service. Siemens Xcelerator also includes an evolving marketplace to facilitate interactions and transactions between customers, partners, and developers.

Dr Peter Koerte Chief Technology and Strategy Officer Siemens AG addresses at Siemens Xcelerator launch in India

Peter Koerte, Chief Technology Officer and Strategy Officer, Siemens AG, said, “India will play a key role in the global roll-out of Siemens Xcelerator. With over 6,000 software engineers at our development centers in the country, India will be at the forefront and a key hub to further accelerate the digital transformation efforts of our customers worldwide. This is both an ambition and a reality.
With the launch of Siemens Xcelerator, I am confident that as partners, Siemens can scale up the innovation and digital transformation journey for customers in India.”

Sunil Mathur, Managing Director and Chief Executive Officer, Siemens Limited, said, “With Siemens Xcelerator, we have taken everything that a customer needs onto one platform, allowing them to accelerate their digital transformation easier, faster, and at scale. SMEs in India will be the greatest beneficiaries of this platform as it can help them to scale up, upgrade and adopt new designs and components much faster to stay competitive. Siemens Xcelerator will help to create a powerful ecosystem of partners who can jointly accelerate digital transformation tailored to specific business goals. Our aim is to help companies to increase their performance, flexibility, and sustainability.”

At Siemens India’s Annual Flagship event ‘Siemens India Innovation Day 2022’, the company showcased a wide range of the latest technologies, innovative solutions, and successful references to help organizations in India accelerate their digital transformation.

Construction of Agra metro inching toward a goal of attaining world-class metro rail system

AGRA (Metro Rail News): Uttar Pradesh Metro Rail Corporation has shared the aerial view of World class Agra Metro Depot on its Twitter handle. Agra inching closer toward the goal of attaining a world-class metro rail system. World-class Agra Metro Depot is being constructed for the first corridor of Agra Metro.

https://twitter.com/OfficialUPMetro/status/1569685200342519812?s=20&t=Ntg2ry0NgerekSmDuqAANg

The depot will be used for stabling and maintaining the metro trains inside the depot area after day-long operations.
Various structures are being made inside Agra Metro Rail Depot using the PEB Technique (Pre Engineered Building ) Technique which is a modern technique for building various civil structures and uses comparatively lesser time, and effort and is more efficient.

The progress of depot construction is going on at a rapid pace and structures like integrated workshops, auto–coach washing plants and stabling yards are being constructed in the depot for various functions.

A shed above these structures is being built and very soon the work of covering these PEB Structures will be complete. Similarly, test track work inside the depot premises is also complete and a pit wheel lathe machine has also been installed in the depot which will be used to check any malfunctions in the wheel, its alignment, etc.

The first corridor of the Agra Metro Rail Project, which runs from Taj East Gate till Sikandara is 14 km long comprising 13 stations. The work on the second corridor will also be begun very soon.

Trial run of RRTS first train will start in November from Ghaziabad

GHAZIABAD (Metro Rail News): The Regional Rapid Transit System (RRTS) project’s first train in the nation would likely start its trial run in November. The first RRTS train will be tested on the 17-kilometer priority section in Ghaziabad, and it will be the first RRTS stretch to be operational in March 2023, officials of the project executing agency, National Capital Region Transport Corporation (NCRTC), stated.

The first two trains have been delivered to the NCRTC by the Savli manufacturing facility in Gujarat, and a third train would be delivered to the Duhai depot in Ghaziabad shortly official added. A control center at the Duhai depot will oversee all train operations for the priority section.

“The work for the viaduct for the 17-km priority section is about 99% complete. Once it is over, the work for laying tracks and installation of overhead equipment will be taken up in the month of October. Thereafter, the trial run will start in November. The trial run will involve the speed test of the trains and will also include a host of other tests for the safety and operational readiness of RRTS trains. The speed test will see the trains touch the 180 kilometers per hour (kmph) mark,” said Puneet Vats, NCRTC chief public relations officer.

The six-coach RRTS trains will run at a design speed of 180kmph. According to official sources, the RRTS trains’ real operating speed will be close to 160 kmph, and their average running speed would be near 100 kmph.

In March 2025, the RRTS project’s entire 82-km phase will connect Delhi, Ghaziabad, and Meerut and would be put into service. According to sources, the NCRTC has proposed 30 trains with six coaches each in addition to 10 trains with three coaches for Meerut’s local transit module.

Official sources added that different departments of the RRTS project will conduct their tests during the trial run. Thereafter, an integrated test of all the systems will take place before the final safety clearance is given for going ahead with passenger operations.

“With the trial run phase nearing, the work for five RRTS stations on the priority stretch is also being expedited and is over 60% complete. These five stations will become fully operational when the priority section starts. Once the trial runs end, the fares will also be rolled out,” Vats added.

The total cost of the 25-station project, located in Delhi and Uttar Pradesh, is estimated at Rs. 30,274 crores.

Railway Minister Ashwini Vaishnaw inspect progress of multi-modal Sabarmati transport hub

MUMBAI (Metro Rail News): Ashwini Vaishnaw, the Union Minister for Railways, visited the locations of the High-Speed Rail (HSR) stations at Sabarmati and Ahmedabad on 13th September and reviewed the development of the Mumbai-Ahmedabad High-Speed Rail Project.

Vaishnaw also went to Gandhinagar and looked over the station’s amenities. He was accompanied by senior railroad officials from Western Railway and National High-Speed Rail Corporation Limited (NHSRCL), including General Manager (In-Charge) of Western Railway Prakash Butani and the Divisional Railway Manager of Ahmedabad Division Tarun Jain.

According to Chief Public Relations Officer of Western Railway Sumit Thakur, Vaishnaw arrived at the Gujarat capital in the morning and inspected the various aspects of passenger-related amenities at the station.

He then rode in the inspection car to conduct a track inspection from Gandhinagar station to Sabarmati station. Vaishnaw also visited the One Station One Product stand at the Sabarmati station. He then arrived at the Sabarmati High-Speed Rail station construction site and review the progress. The railway minister also viewed the miniature model of the upcoming future Sabarmati HSR station. Officials from NHSRCL informed him of the numerous advances and progress made on the project. He interacted with the workers and encouraged their spirits by appreciating their efforts in the nation-building.

Vaishnaw went to the top of the Jhulta Minar in Ahmedabad and conducted a detailed inspection by going to the top of the structure.

Vaishnaw spoke with media representatives and gave them updates on the Vande Bharat Express and Bullet Train trains, Thakur stated. The rail minister revealed details regarding the Bullet Train project, saying that more than 80 kilometres of piers have been constructed. The installation of decks, viaducts, tracks, and overhead equipment is progressing.

Big Efforts for City Decongestion: Bangalore Peripheral Ring Road

Peripheral Ring Road (PRR)

The PRR is planned as a 74 km stretch with a 100-meter-wide road. On completion, it will connect Tumakuru Road and Hosur Road via Hessaraghatta Road, Doddaballapur Road, Ballari Road, Hennur-Bagalur Road, Old Madras Road, Hoskote-Anekal Road, and Sarjapur Road. Along with NICE Road, which links Tumakuru Road and Hosur Road via the city’s northwestern, western and southwestern areas, Bengaluru will have a 116-km-long bypass on its periphery.

The proposed alignment of PRR will be located at an approximate radial distance of 17 km – 25 km from the city center and is envisaged to be a bypass to the city for the long-distance personalized vehicles (cars and cabs) and commercial vehicles (trucks and LCVs). The total land requirement for the project, which was initially estimated to be 733 hectares (1811.28 acres), was later revised to 1036.51 hectares (2561.27 acres) due to the change in length of PRR from 65.5 km to 74 km. The increase in length was due to realignment and inclusion of cloverleaf structures to integrate at Tumkur Road and Hosur Road with NICE road.

The project’s total cost is Rs 14,934 crores, out of which Rs 9,318 crore is required for land acquisition and rehabilitation purposes, while the construction cost is estimated to be around Rs 5,600 crores. The state government has already provided administrative approval for the project. When originally conceptualized 15 years ago with the aim of decongesting Bengaluru and easing traffic, the project was estimated to be Rs 3,000 crore. But due to design, rapid urbanization, and land acquisition challenges, the project could never take off despite repeated attempts.

The project is very significant to Bangalore city because it is expected to address serious traffic challenges. According to local authorities and the state government, Bengaluru needs PRR given the massive geographical expansion of the city to the current spread of 2196 sq km and explosive growth of vehicular ownership (2019 estimate – over 80 lakhs). The ring road is also expected to provide massive economic benefits. Bengaluru has been attempting to complete several large ring road projects to improve its city-region connectivity and alleviate traffic congestion. A Satellite Town Ring Road (STRR) is currently under construction.

Environmental Issues

OGDnd 33tZN4xFt4pUvIAlcVTlFn2fx48lNnr8bVPsE0J9 Wv4 XLYrC 9CH6d vBh D hF00j5 rlDmDKBLoKXuAaAU0 4s76 QzpIBEOM0LKoX1fu4hJUIHrC7YnTm8hsSAICQrfqo0

The project has received initial environmental clearance, which was required as it involves the diversion of 7.91 hectares (19.54 acres) of forest land in the Jarakabandekaval reserve forest. Since the boundary of Bannerghatta National Park and Puttenahalli bird conservation reserve is located at a distance of 7.21 Km and 1.49 Km, respectively, additional approvals were required. The proposed PRR alignment is close to Peenya Industrial Area and Jigani-Bommasandra Industrial Area, which are notified as severely polluted and critically polluted areas by CPCB.

As per the environmental impact assessment (EIA) done for the project, 36,824 trees will have to be uprooted for the project. At Thippagondanahalli reservoir, 20 km of the proposed road will be built and 13,355 trees will come in the way of the project. More than 630 trees have been identified in the Jarakabande Kaval reserve forest area.

Environmental groups also say that there are six lakes along the proposed road alignment, and construction will result in a significant loss of habitat for small mammals like squirrels and bats and birds like the Black kite, Brahminy kite, Common buzzard, and the Indian peafowl. They argue that about 555 hectares (1,371 acres) of farmland will also be lost to the PRR.

BDA has proposed to mitigate the impact of the PRR on the environment by planting ten trees for every tree removed (a total of 3,38,380 trees to be plated). BDA has also undertaken to erect barriers on both sides of the road construction site to mitigate dust and air pollution. It has promised that no materials will be dropped from a height greater than 3 feet to minimize dust and that water will be sprinkled on the construction site at least three times a day.

It is also to note that, approximately 33,000 trees will be felled for PRR development, which has sparked concerns from environmentalists. This project will also affect forest land in Jarakabandekaval and six water bodies. The authorities have laid out a plan for planting trees in lieu of those that would be axed. However, the final Environmental Impact Assessment (EIA) report is still awaited as some details of the project have now been revised. To construct the PRR in Bangalore, land in around 67 villages will have to be acquired, spread across 8 districts. These are:

  • Yeshwanthpur
  • Hesaraghatta
  • Yelahanka
  • KR Puram
  • Bidhrahalli
  • Varthur
  • Sarjapur
  • Attibele

Land Acquisition Challenges

A major legal hurdle for the project was cleared in Nov 2021 after the Supreme Court directed the Karnataka government and the Bangalore Development Authority to acquire the land for the formation of PRR and proceed to implement the project. The SC permitted the project to go ahead in response to an affidavit filed by the Additional Chief Secretary, Government of Karnataka, Urban Development Department, Bengaluru.

Of the total land notified, government land consists of about 114.20 hectares, Kharab land consists of 43.43 hectares, and the remaining private land is 555.57 hectares. A section of land owners oppose BDA’s proposal to compensate them under the BDA Act and have demanded compensation under the Right to Fair Compensation and Transparency in Land Acquisition Act 2013. According to an estimate by BDA that was done in 2021, the land acquisition cost would shoot up by more than Rs 14,000 crores if the compensation package is fixed as per the 2013 Act. Even when the Congress-led United Progressive Alliance government passed the bill in 2013, the critics pointed out that it would increase the cost of infrastructure dramatically. While the National Democratic Alliance government attempted to dilute the law by ordinances etc, it abandoned the idea after opposition from allies and a lack of majority in the Rajya Sabha. BDA and the state government may need to come up with some innovative funding ideas to resolve the problem.

Timeline & Major Phases

  • The project was mooted in 2005-06 by the then government.
  • Between 2006 and 2010, the land acquisition process hit a roadblock with a number of landowners approaching Courts.
  • In 2011, the High Court canceled the project due to delays. The government then revised the length of the road to 65 km and sought the Court’s permit for land acquisition.
  • The project got environmental clearance in 2014, and by 2015, the Urban Development Department gave its assent to the project.

Now, with the Supreme Court giving its nod for land acquisition, the project has been brought back to life. Also, the original length of the road has been revised from 65 km to 73.5 km to enable the linking of the road with the BMICP Expressway, or the NICE Road as it is locally called. Japanese agency, Japan International Cooperation Agency (JICA), was roped in to finance this project. Initially, the project’s cost was pegged at Rs 3,000 crore, which has jumped to Rs 21,000 crore now, with land acquisition forming the bulk of this amount.

Summary

The Peripheral Ring Road (PRR) is the third Ring Road of Bangalore developed by the Bangalore Development Authority (BDA). The 73 km circular road will lead from Hosur Road and connect to Tumakaru Road and NICE Road to form a complete circle around the boundaries of Bangalore.

After being on the drawing board for several years, the Peripheral Ring Road Project (PRR) has finally received a nod from the Karnataka government. The mega project would encircle the peripheral areas of Bangalore, the city best known for its IT/ITeS hubs and new-age businesses. Once through, the development will create new connectivity points and fillip the realty landscape in Bangalore by and large.

Special Features

As per the plans, the Peripheral Ring Road will be a 73 km circular road, with eight lanes (100 meters wide) and four service lanes. It will cover areas of  North and East Bangalore and Anekal. The stretch will start from NICE Road Junction at Tumkur Road, pass through Bellary Road, Old Madras Road and end at National Highway- 44 on Hosur Road. Further, it will also be integrated with the semi-circular NICE Road near BIEC and near Konappana Agrahara.

About 2,400 acres of land are expected to be acquired for the road. The project will be executed via a public-private partnership on the Design-Build Finance Operate and Transfer model. The road developer will get a concession to collect tolls for 50 years to meet the funding targets of the project and recover its costs and profits. Once completed, the road will have 17 toll plazas and two clover field junctions at Old Madras Road and Airport Road. A total of nine entry and exit points have been identified with five flyovers, four underpasses, and five Railway Overbridges (ROB).

As per the project plan, someplace in the median will be left vacant for metro projects in the future. It will also have provisions for a helipad and electronic charging stations for EVs.

The Need for the Third Ring Road

At present, Bangalore has two Ring Roads. The Inner Ring Road links Indiranagar to Koramangala, while the Outer Ring Road (ORR), which is 60 km long, links all the highways that converge into Bangalore, including five National and five State Highways. These include Mysore Road, Bannerghatta Road, Tumkur Road, Magadi Road, and Kanakpura Road, among others.

It is estimated that more than 10,000 heavy vehicles use the Outer Ring Road, which is also facing pressure from the growing real estate around it. The new Kempegowda International Airport also pushes the vehicular traffic here. Keeping in mind the traffic burden on existing roads and the increasing number of new vehicles in Bangalore (the district is witnessing a 10 percent annual vehicle growth), the Peripheral Ring Road received renewed interest from policymakers.

Latest Update

In April this year, the Bangalore Development Authority (BDA), the nodal authority tasked with the responsibility for providing civil amenities for the metropolis, floated a global tender inviting construction infrastructure firms to submit bids to develop a greenfield 8-lane, 74 km PRR through a public-private partnership (PPP) on design, build, finance, operate and transfer model (PPP-DBFOT).

It may be noted that the tenders were previously invited in March but have to be scrapped at the last moment due to technical glitches. This is the second time the tenders have been floated without any changes in the terms and conditions. Earlier, the farmer’s agitation delayed the construction as disputes relating to land acquisition reached the Courts. However, the authorities have now received a go-ahead from the Supreme Court. Global tenders were invited by BDA last year. An Israeli firm, Symba Maz, has expressed interest to invest in this project, the cost for which has now escalated to Rs 21,250 crore.

As per the tender terms, the winning concessionaire will get a 50-year lease period for collection of the toll to recover the cost and then hand over the project to the State Government. The winning concessionaire would also be required to pay upfront part of the land-acquisition cost. The BDA also notified the last date for submission of the bids as May 18 and the bid opening date was May 20. However, as per few reports in June again, BDA decided to scrap the tender process and announced that it would issue a fresh one. The decision to scrap the tender was attributed to queries from potential investors who participated in the tender process, seeking clarification on the land acquisition cost.

The government has created a Special Purpose Vehicle (SPV) called the Bengaluru PRR Development Corporation Ltd for implementing this project. Formal tenders are expected to be invited soon to finalise a developer for this road. With the Cabinet approval in place, the project seems to be moving up from the drawing board to the implementation stage. Once constructed, this road project would significantly ease the high-traffic areas and have a strong effect on the real estate market in Bangalore.
